- Town Government
- Engineering
- Maine Street Streetscape Project
Maine Street Streetscape Project

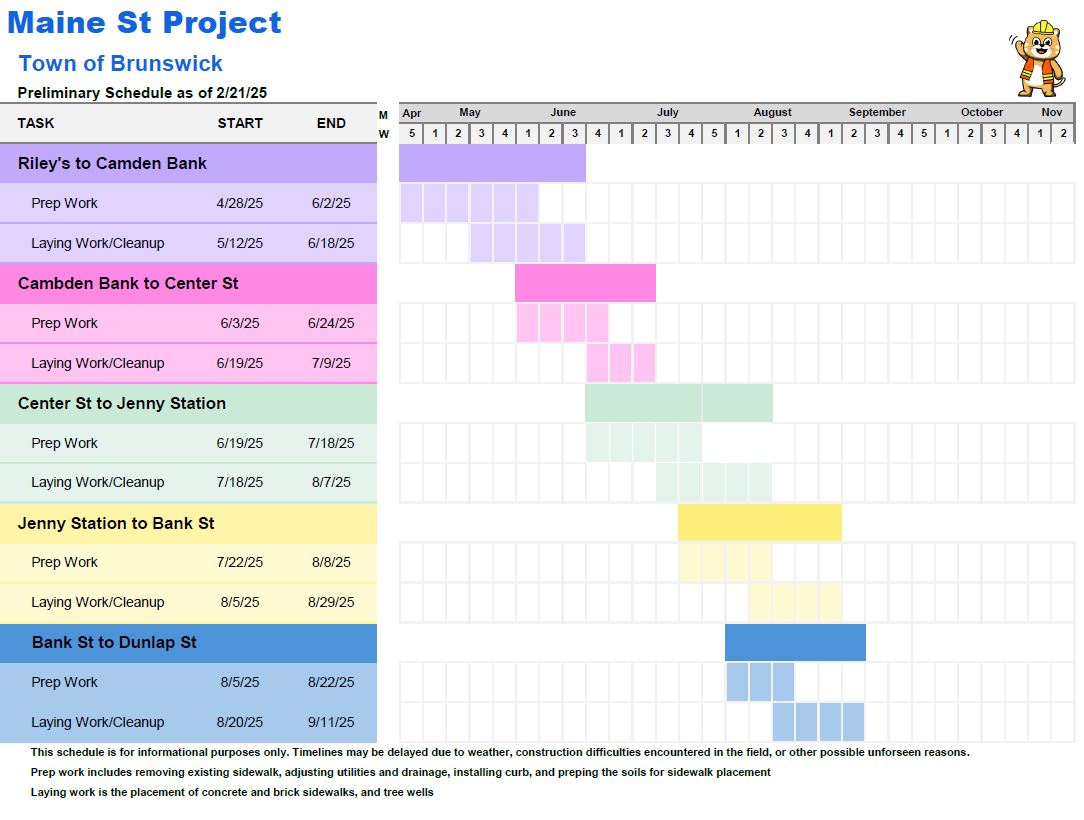

- Due to favorable weather conditions, the east side of the project will begin on April 7, about three weeks ahead of schedule. Please scroll down for a high level schedule of when blocks will be worked on.
- For the past several months, Maine DOT and the Town have had discussions about the Pleasant Street traffic project, and the implications for the Pleasant/Maine intersection. Engineers are reviewing the grading, turning radius, and electrical connection and placement for the traffic signals. As the town is still waiting on the status of a federal grant, we have temporarily paused construction of the intersection of Maine St and Pleasant St. Depending on the grant, the town will either provide a temporary solution for tripping hazards or proceed with the original design the following year.
- Town Public Works removed one of the raised crosswalks near the south side of the intersection of Lincoln/Bank St. This was temporarily removed due to ADA concerns as the two sides of the project are completed at different times. Once the other side of the block has been built, the raised crosswalk will return. In lieu of this crosswalk, the town has added an additional temporary marked crosswalk on the north side of this intersection. This temporary crosswalk will be removed once the raised crosswalk is reinstalled next year.
Scroll down for more information on current parking restrictions and alternative parking locations!
August 7, 2024
RE: Maine Street Trees and the Streetscape Project
To the Residents of Brunswick:
As discussed at the public forum held on Monday, August 5, the Town is moving forward with the Maine Street sidewalk reconstruction as designed and approved by the Town Council. This will result in the likely loss of the remaining trees that are currently present on Maine Street within the project area. However, staff will continue to assess each tree individually when construction approaches their block and make every effort to preserve an existing tree if does not conflict with accessibility requirements and the long-term success of the sidewalk.
The removal of our existing trees is not due to a lack of agreement or understanding about the role that trees play in Brunswick. However, the accessibility of our Maine Street sidewalks for residents, businesses, and visitors is too great of a need to ignore. Compliance with the Americans with Disability Act (ADA) requirements is not a luxury, it is a necessity for a community like ours that values inclusiveness.
This is not an easy decision. The benefits of urban trees are well-known and there is no question that they provide incredible value in important ways. It is why the Town has committed to planting more trees on Maine Street with this sidewalk reconstruction project than previously existed. It is also why the new trees will be planted with substantial improvements to their environment to help them flourish into healthy, mature trees that will once again line Maine Street.
As always, the Town Council appreciates the comments and suggestions from everyone that has reached out on both sides of this issue.
Sincerely,
Abby King
Chair, Brunswick Town Council
Q: Are any of the existing street trees to be removed?
A: Yes, unfortunately some of the existing trees will be removed during the project. The Town's Tree Committee had a group of arborists review the existing trees for health. 14 trees are to be removed on the west side due to declining health, while 8 mature trees will remain. These remaining trees will be monitored during construction in an attempt to preserve them. All trees that are removed will be replaced with new trees plantings. The trees on the east side will be evaluated in 2025.
Q: What happened to the elm tree in front of Frosty's?
A: It was with a heavy heart that the town arborist did okay the removal of the tree, it was not an easy decision to do so. A new water main was installed to the building on one side, and a new storm water drain was being installed on the other side of the tree. Over 40% of the feeder roots were removed during the prep and installation, even after the town ordered changes to the storm water plans to move it away from the tree as far as possible to protect it. The arborist inspected the tree during and after excavation, and could not find any structural roots under the sidewalk either. The risk of the tree falling was a very large concern, and the damage to the feeder roots was too great for the tree to survive.
Q: Why are native tree species not being planted back?
A: The Curator of the Royal Public Garen in London England said it best “ trying to put a native tree in a nonnative environment ” this will give a tree a disadvantage before it even starts. Selecting trees to put in a harsh environment like sidewalks tree wells is hard enough and require special trees to be planted for their long-term survival. They are selected to not only provide the esthetics and shade required but will respond to the local conditions as they evolve at the same time. Trees are selected for the adaptability to soil conditions, environmental conditions, drought tolerance, small root growth zones and winter survival. Street trees at the start are given a live expectancy on average of 19-28 year and an annual mortality Rate of 3.5-5.1%. Selecting trees that will survive the odds plays a large factor in their selection.
Q: What time will construction work happen?
A: Generally construction will begin shortly after 7am and continue until about 5pm on Monday through Friday. No construction is planned for on weekends or prior to 7am or after 7pm.
Q: Will the businesses be open during construction?
A: Yes, businesses are expected to be open and accessible during the construction project. There may be brief moments where a store is inaccessible as equipment is moved or work performed, but otherwise special ramps will be provided to help pedestrians enter stores while the contractor does their best to coordinate around business hours.
Project Overview
The Town of Brunswick is reconstructing its Downtown Streetscape. The project generally consists of the full depth reconstruction of approximately 5,000 square yards of sidewalks along Maine Street and includes the removal and replacement of all granite curbing, construction of concrete and brick sidewalks, driveways, accessible ramps, tree pits, and associated landscaping.
Construction began on May 6, 2024 on the west side of Maine Street. Starting near The Great Impasta, the construction crew will move block by block from Mill Street south towards Pleasant Street. The construction crew will then demobilize for the winter and begin the east side of Maine Street in Spring 2025.
News and Traffic Alerts
Sign up for news alerts at the Notify Me page to receive important updates on the project and other town affairs. Watch our video on how to use Notify Me.
Questions, Comments, and Concerns
Please contact TOB-Engineering@brunswickme.gov for additional information
Construction Plans and Specifications

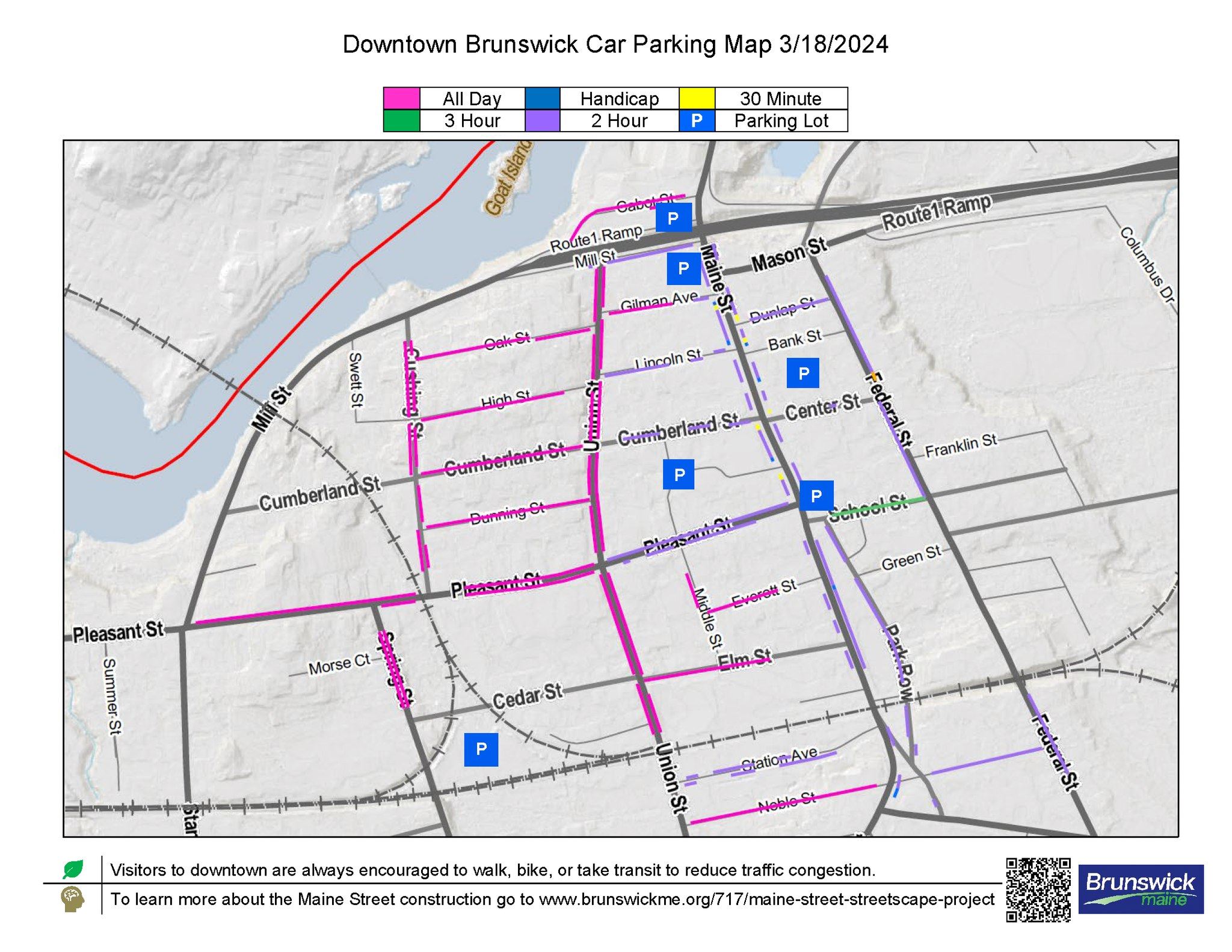

On street parking will be limited where construction crews are presently working. Flaggers will be at the beginning and ending of all closures to help escort customers into the businesses affected. Please support our local downtown businesses as we work through this project together. Check back for latest updates on the closures or sign up for Notify Me to receive a weekly update.

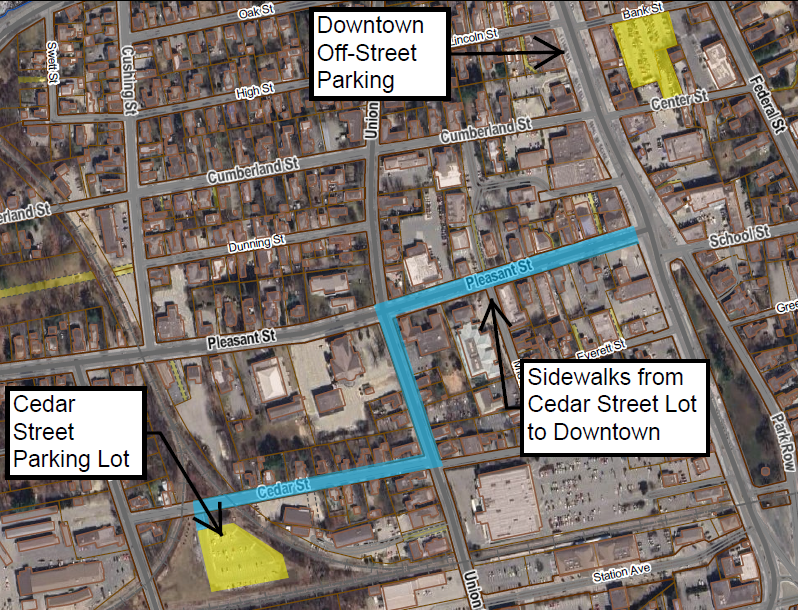

Avoid the hassle of navigating through construction and wasting time looking for a parking spot! Park stress-free at the Cedar Street parking lot less than one mile from downtown. Enjoy a leisurely stroll to downtown where you can pass by restaurants, shops, and the Curtis Memorial Library. It's a small step to save you time and frustration!
